Commissioning sheet template
A commissioning record for AV and network installs, from the first visit to client handover. Test inputs, audio levels, cable outlets, switch power and wireless, log each product with its serial and photos, track snags, then record documents, training and signatures. Every question is listed below, and you can fill the live form in on this page.
Ready to use from the form library, and editable. Trial from £1, cancel any time.
What should a commissioning sheet include?
A commissioning sheet should say what was tested, where, when, by whom and against which specification. For each system it records the readings, the limit and a pass or fail result. It then lists the installed products with serial numbers, the snags still open, the documents and training handed over, and signatures from the engineer and the client.
Last updated . Facts checked on 26 September 2026 against regulation 44 of the Building Regulations 2010.
Try the commissioning form live
Answer a few questions and watch it adapt. Your answers are not saved, and any photos you add are deleted within the hour.
This is the real form as your team would use it: questions appear as you answer, scores work themselves out and you can add photos and signatures. No sign-up needed.
Fill it in on a phone or tablet
Your team completes the av commissioning record on site in the SiteSurvey app on iPhone, iPad and Android phones and tablets. The project name and address fill in for them, it works without signal, and it syncs when the device is back online with photos kept against the question they answer.
Customers and subcontractors do not need the app: send them a link and they can fill it in from any browser.


Every question in the commissioning template
Commissioning and handover for AV and network installs: tests, equipment and photos, snags, documents and training. 8 sections and 106 questions. Follow-up questions and guidance appear only when an answer calls for them, so the person on site never sees the ones that do not apply.
Details you only enter once
Add this form to a project in SiteSurvey and it fills in what the project already knows, so nobody on site retypes it and every form on the job uses the same names. Anything filled in can still be changed.
- Project: the project name
- Site and room: the site, when the form is opened for a space or a product
- Client: the project's customer
Project and visit
What is being commissioned, where, and at what stage.
- ProjectShort answerFills in from the project name
- Record referenceShort answer
- Site and room*Short answerFills in from the site, when the form is opened for a space or a product
- ClientShort answerFills in from the project's customer
- Date of the tests*Date
- Commissioning engineerShort answer
- Stage of the project*Choose one
- Before installation
- During installation
- After installation
- Closeout
- GuidanceBefore installation. Record what can be checked now: the room, the fixings, power, containment and the delivered equipment. Performance tests come later.Shown when “Stage of the project” is “Before installation”
- Is the room ready for the installation?Yes or NoShown when “Stage of the project” is “Before installation”
- What is not ready, and who needs to act?NotesShown when “Stage of the project” is “Before installation” and “Is the room ready for the installation?” is No
- GuidanceCloseout. Tests should already be recorded. This visit records the documents, the training and the client's acceptance.Shown when “Stage of the project” is “Closeout”
- Type of visitChoose one
- First commissioning visit
- Return visit after remedial work
- Client walkthrough
- Reference of the earlier recordShort answerShown only when the answers above make it relevant
- Which failed items are being tested again?NotesShown when “Type of visit” is “Return visit after remedial work”
- Do you have the project specification and schedules with you?Yes or No
- Documents and revisions usedShort answerShown when “Do you have the project specification and schedules with you?” is Yes
- WarningNothing to test against. A system is verified against what was agreed for the project. Without the specification, record what you find but do not mark a test as passed.Shown when “Do you have the project specification and schedules with you?” is No
- Systems covered by this recordTick all that apply
- Display and video
- Audio
- Control
- Cabling and cabinet
- Network switch
- Wireless
- Could everything in scope be tested?Yes or No
- What could not be tested, and why?NotesShown when “Could everything in scope be tested?” is No
- Date it will be testedDateShown when “Could everything in scope be tested?” is No
Display and audio
Limits come from the project specification. Enter them as written there.
- Inputs testedNumberShown only when the answers above make it relevant
- Inputs that gave picture and soundNumberShown only when the answers above make it relevant
- Inputs passed (%)Worked out by the formShown only when the answers above make it relevant
- WarningFail. Not every input passed. List the inputs that failed and raise a snag for each one.Shown only when the answers above make it relevant
- Which inputs failed, and what happened?NotesShown only when the answers above make it relevant
- GuidancePass. Every input tested gave picture and sound.Shown only when the answers above make it relevant
- Any defective pixels on the test screens?Yes or NoShown only when the answers above make it relevant
- How many?NumberShown when “Any defective pixels on the test screens?” is Yes
- Number allowed by the specification or the makerNumberShown when “Any defective pixels on the test screens?” is Yes
- WarningFail. More defective pixels than allowed. Photograph the screen and raise a snag.Shown only when the answers above make it relevant
- Speaker polarity checked and correct?Yes or NoShown when “Systems covered by this record” includes “Audio”
- Which speakers are wrong?Short answerShown when “Speaker polarity checked and correct?” is No
- Any buzz or rattle on the test tone?Yes or NoShown when “Systems covered by this record” includes “Audio”
- Where is it coming from?Short answerShown when “Any buzz or rattle on the test tone?” is Yes
- Quietest seat (dBA)NumberShown when “Systems covered by this record” includes “Audio”
- Loudest seat (dBA)NumberShown when “Systems covered by this record” includes “Audio”
- Difference allowed by the specification (dB)NumberShown when “Systems covered by this record” includes “Audio”
- Difference between seats (dB)Worked out by the formShown when “Quietest seat (dBA)” is answered and “Loudest seat (dBA)” is answered
- GuidancePass. The difference between the quietest and loudest seat is within the limit you entered.Shown only when the answers above make it relevant
- WarningFail. The difference between seats is more than the limit you entered. Rebalance the speakers and measure again.Shown only when the answers above make it relevant
- CheckNo limit entered. The reading is recorded, but it cannot be marked pass or fail without the figure from the specification.Shown only when the answers above make it relevant
- Result for display and audioChoose one
- Pass
- Fail
- Not tested
Cabling, cabinet and switch
Outlets tested, labels, power and temperature.
- Outlets testedNumberShown only when the answers above make it relevant
- Outlets passedNumberShown only when the answers above make it relevant
- Outlets failedWorked out by the formShown only when the answers above make it relevant
- Outlets passed (%)Worked out by the formShown only when the answers above make it relevant
- WarningFail. One or more outlets failed. List them, repair and test again before handover.Shown only when the answers above make it relevant
- Which outlets failed, and on which test?NotesShown only when the answers above make it relevant
- Is the tester within its calibration date?Yes or NoShown only when the answers above make it relevant
- Date on the calibration certificateDateShown when “Is the tester within its calibration date?” is Yes
- CheckResults from a tester that is out of calibration may not be accepted. Say so on the record and agree with the client whether to test again.Shown when “Is the tester within its calibration date?” is No
- Tester results filePhotosShown only when the answers above make it relevant
- Do the labels match the cabling schedule?Yes or NoShown only when the answers above make it relevant
- Which labels are missing or wrong?NotesShown when “Do the labels match the cabling schedule?” is No
- Switch power budget (W)NumberShown when “Systems covered by this record” includes “Network switch”
- Power drawn by connected devices (W)NumberShown when “Systems covered by this record” includes “Network switch”
- Power budget used (%)Worked out by the formShown only when the answers above make it relevant
- WarningOver budget. The devices draw more power than the switch can supply. Some may not start, or may drop out.Shown only when the answers above make it relevant
- Air into the cabinet (°C)Number
- Air out of the cabinet (°C)Number
- Rise allowed by the specification (°C)Number
- Temperature rise (°C)Worked out by the formShown when “Air into the cabinet (°C)” is answered and “Air out of the cabinet (°C)” is answered
- WarningFail. The cabinet is running hotter than the limit you entered. Check the fans, the blanking panels and the space around the cabinet.Shown only when the answers above make it relevant
- Result for cabling, cabinet and switchChoose one
- Pass
- Fail
- Not tested
Wireless network
The network as a whole. Readings for each access point go with the product in section 5.
- Access points installedNumber
- Access points onlineNumber
- Access points offlineWorked out by the formShown only when the answers above make it relevant
- WarningFail. Not every access point is online. Say which ones, and raise a snag.Shown only when the answers above make it relevant
- Which access points are offline?Short answerShown only when the answers above make it relevant
- Did a test device join each network?Yes or No
- Which network failed, and what happened?Short answerShown when “Did a test device join each network?” is No
- Is there a guest network?Yes or No
- Is it kept apart from the staff network?Yes or NoShown when “Is there a guest network?” is Yes
- WarningFail. A guest device can reach the staff network. Do not hand the network over until this is fixed.Shown when “Is there a guest network?” is Yes and “Is it kept apart from the staff network?” is No
- Result for wirelessChoose one
- Pass
- Fail
- Not tested
Equipment and photos
One entry for each product, against the room it is in.

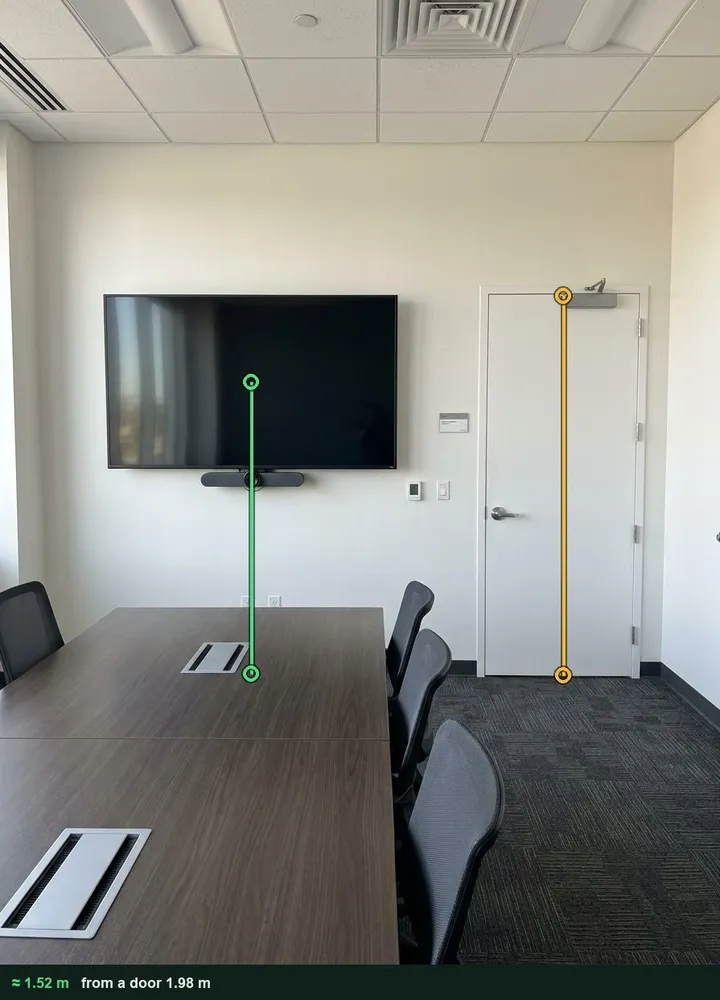

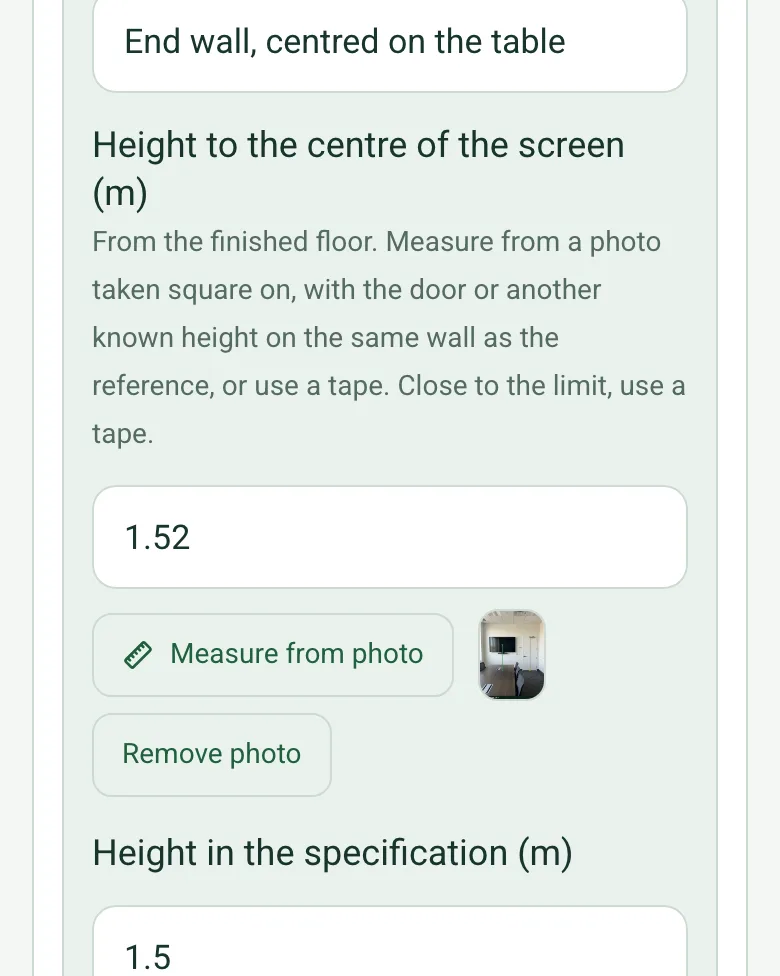

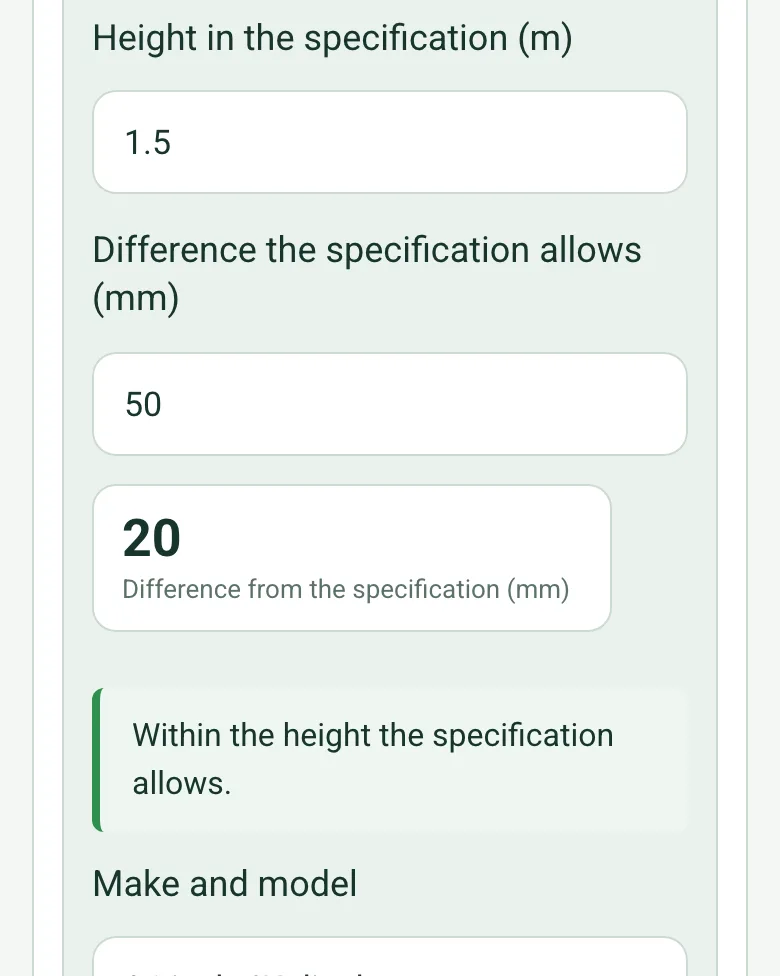

- GuidanceWhat a good photo shows. The item as installed and finished, with its surroundings. For a cabinet, open the door and show the patching and the status lights.

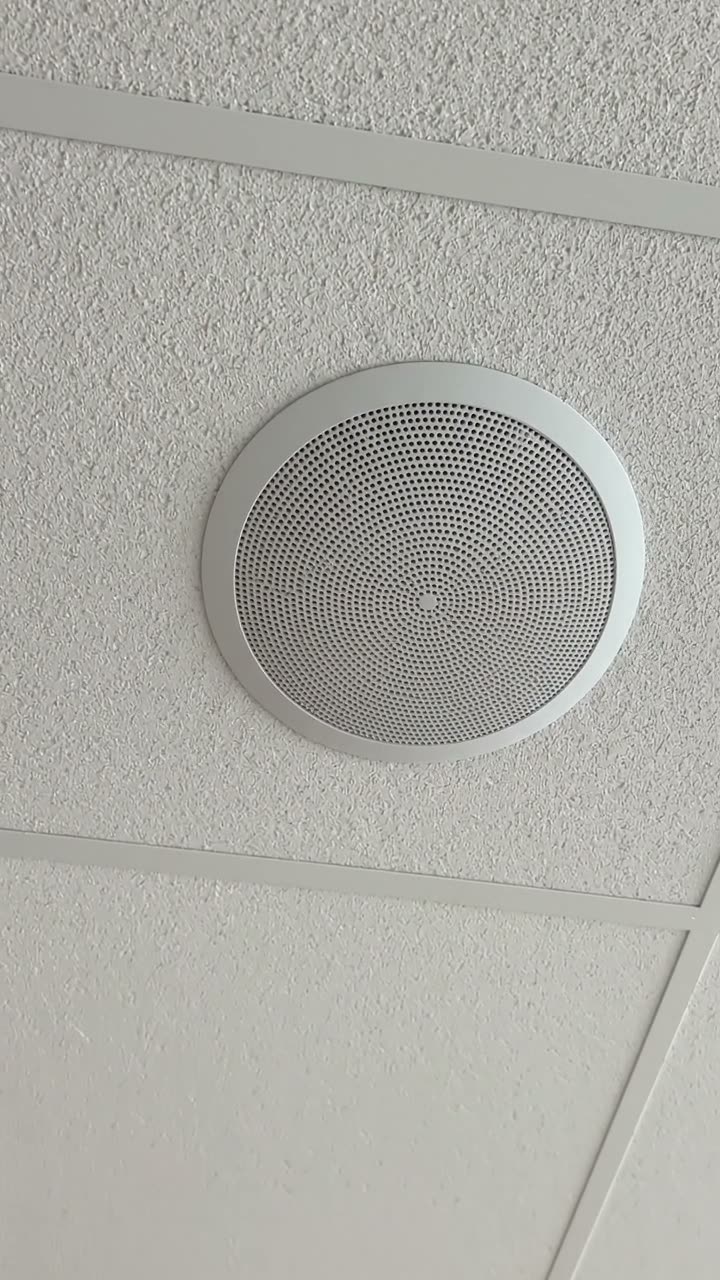

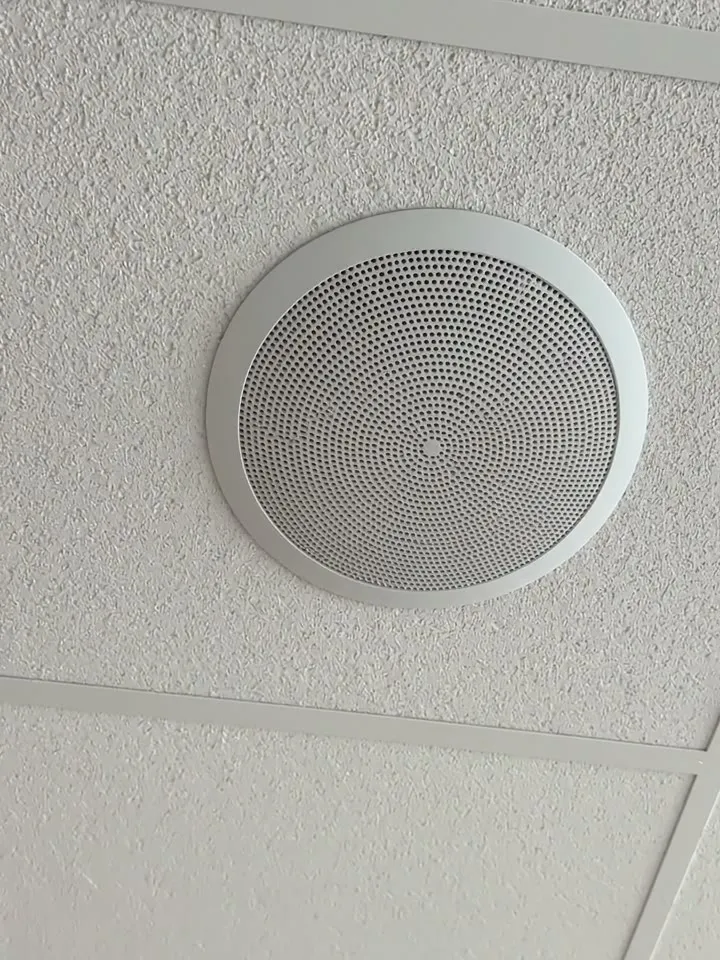

A ceiling speaker fitted flush in a suspended ceiling tile

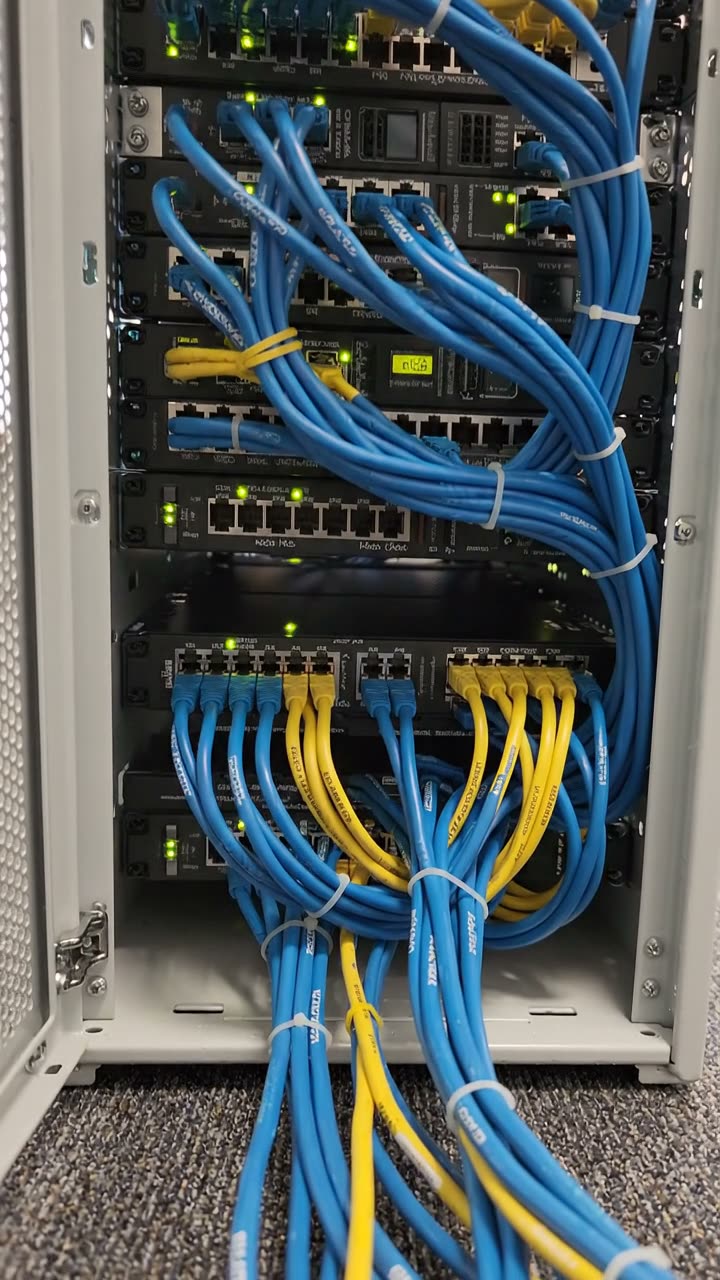

An open network cabinet with blue and yellow patch leads tied in bundles

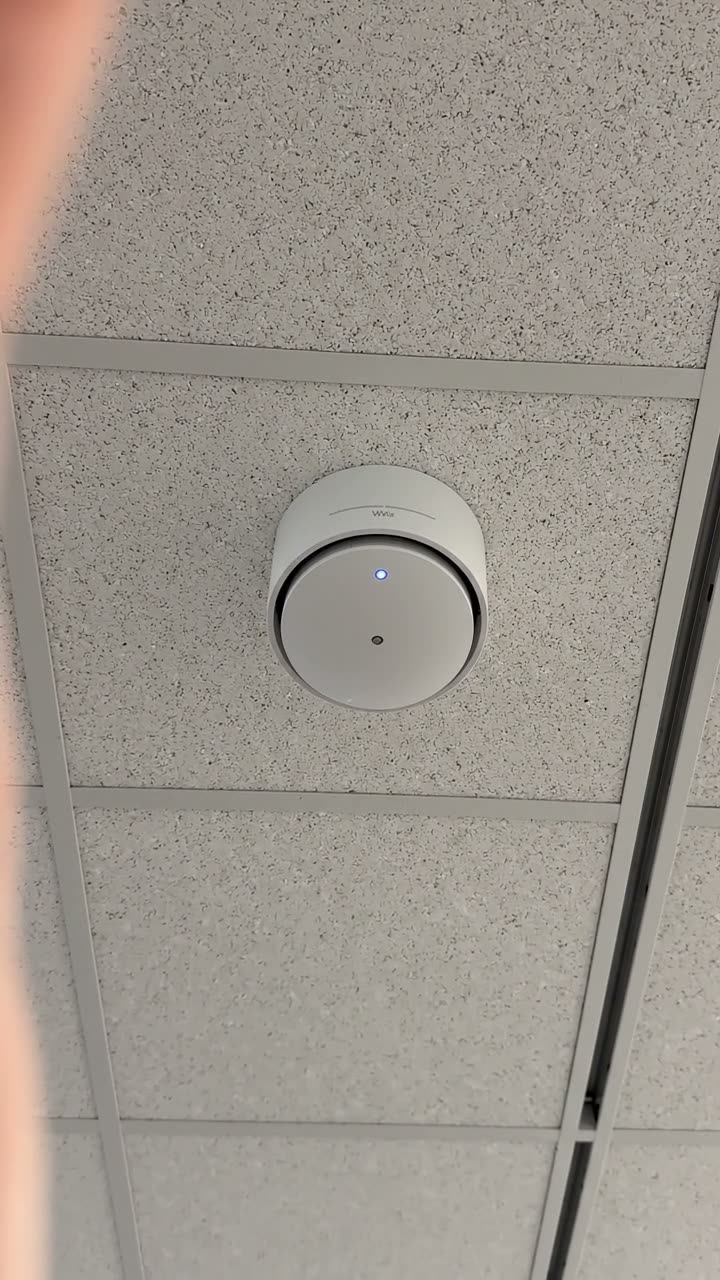

A wireless access point on a ceiling grid with its status light on - ProductsRepeat for each product. Each one asks:
- ProductChoose one
- Display
- Ceiling speaker
- Amplifier or audio processor
- Microphone
- Camera
- Control panel
- Table connection box
- Wireless presentation receiver
- Network switch
- Wireless access point
- Cabinet
- Other (describe)
- Room and positionShort answer
- Make and modelShort answer
- Does it have a serial number?Yes or No
- Serial numberShort answerShown when “Does it have a serial number?” is Yes
- Asset label or other markShort answerShown when “Does it have a serial number?” is No
- MAC addressShort answerShown only when the answers above make it relevant
- Firmware or software versionShort answerShown only when the answers above make it relevant

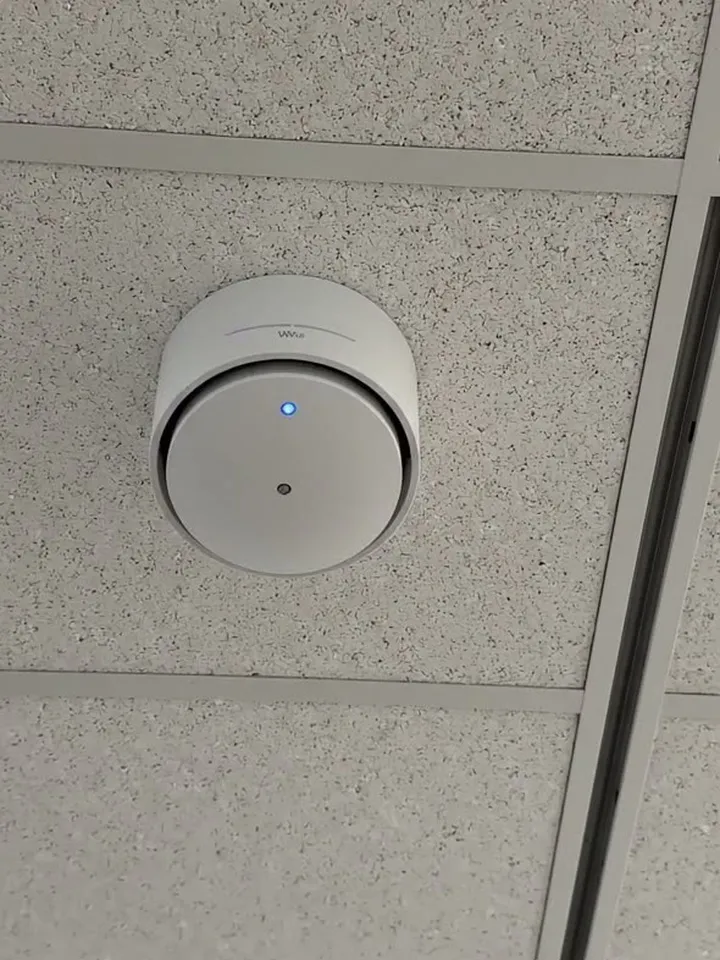

- Is the access point online?Yes or NoShown when “Product” is “Wireless access point”
- What is wrong?Short answerShown when “Product” is “Wireless access point” and “Is the access point online?” is No
- WarningFail. This access point is offline. Signal cannot be tested until it is back.Shown when “Product” is “Wireless access point” and “Is the access point online?” is No
- Weakest reading in the room (dBm)NumberShown when “Product” is “Wireless access point” and “Is the access point online?” is Yes
- Target in the specification (dBm)NumberShown when “Product” is “Wireless access point” and “Is the access point online?” is Yes
- Better than target by (dB)Worked out by the formShown when “Product” is “Wireless access point” and “Is the access point online?” is Yes and “Weakest reading in the room (dBm)” is answered and “Target in the specification (dBm)” is answered
- GuidancePass. The weakest reading is at or better than the target you entered. Signal is a negative number, so -58 is stronger than -65.Shown only when the answers above make it relevant
- WarningFail. The weakest reading is below the target you entered. Record where in the room it was taken.Shown only when the answers above make it relevant
- Where was the weakest reading taken?Short answerShown when “Product” is “Wireless access point” and “Is the access point online?” is Yes and “Weakest reading in the room (dBm)” is answered
- Does it match the equipment schedule?Yes or No
- What is different, and who agreed the change?NotesShown when “Does it match the equipment schedule?” is No
- CheckThis item does not match the schedule. Record who agreed the change, or raise it as a snag in section 6.Shown when “Does it match the equipment schedule?” is No
- As-installed photosPhotos
Snags and remedial work
Anything that failed, is missing or needs a return visit.
- CheckYou recorded a failed result in an earlier section. Add a snag for each failure.Shown only when the answers above make it relevant
- Are there any snags?Yes or No
- SnagsRepeat for each snag. Each one asks:Shown when “Are there any snags?” is Yes
- What is wrong, and where?Notes
- Effect on handoverChoose one
- Room can be used
- Room can be used with a limit
- Room cannot be used
- What is the limit?Short answerShown when “Effect on handover” is “Room can be used with a limit”
- WarningThis snag stops the room being used. It should be closed and tested again before the client is asked to sign.Shown when “Effect on handover” is “Room cannot be used”
- PhotosPhotos
- Fixed and tested again on this visit?Yes or No
- What was done?Short answerShown when “Fixed and tested again on this visit?” is Yes
- Who will fix it?Short answerShown when “Fixed and tested again on this visit?” is No
- Due dateDateShown when “Fixed and tested again on this visit?” is No
- Snags raisedNumberShown when “Are there any snags?” is Yes
- Snags closedNumberShown when “Are there any snags?” is Yes
- Snags still openWorked out by the formShown when “Are there any snags?” is Yes and “Snags raised” is answered and “Snags closed” is answered
Handover documents and training
What the client is given, and what is still to come.
- Documents handed overTick all that apply
- Equipment list with serial numbers
- Test results
- As-built drawings
- Configuration backup
- User guide
- Maker's manuals
- Warranty details
- Other (describe)
- Are any documents still to come?Yes or No
- Which documents, and by when?NotesShown when “Are any documents still to come?” is Yes
- Were passwords or logins handed over?Yes or No
- Who received them, and how?Short answerShown when “Were passwords or logins handed over?” is Yes
- CheckDo not write passwords on this record. Record only who received them and how.Shown when “Were passwords or logins handed over?” is Yes
- Was training given on this visit?Yes or No
- Who attended?Short answerShown when “Was training given on this visit?” is Yes
- Date training is booked forDateShown when “Was training given on this visit?” is No
Result and sign-off
The engineer signs for the tests. The client signs for what they saw working.
- Overall resultChoose one
- Pass
- Pass with open snags
- Fail
- WarningYou chose Pass, but a section is marked Fail or snags are still open. Check the result before you sign.Shown only when the answers above make it relevant
- CheckPass with open snags. The client should see the list of open snags and their due dates before signing.Shown when “Overall result” is “Pass with open snags”
- WarningFail. The system is not ready to hand over. A return visit is needed.Shown when “Overall result” is “Fail”
- Date of the return visitDateShown when “Overall result” is “Fail”
- Engineer nameShort answer
- Engineer signatureSignature
- Is the client here to countersign?Yes or NoShown only when the answers above make it relevant
- Client name and roleShort answerShown when “Is the client here to countersign?” is Yes
- Client countersignatureSignatureShown when “Is the client here to countersign?” is Yes
- GuidanceThe signature records that the client saw the systems working as described on this date. It does not replace the contract or the warranty.Shown when “Is the client here to countersign?” is Yes
- Date of the client walkthroughDateShown when “Is the client here to countersign?” is No
Commissioning template questions
What does this commissioning checklist test?
It covers display inputs and defective pixels, speaker polarity, buzz and the level difference between seats, cable outlets passed, tester calibration, labelling, the switch power budget and the cabinet temperature rise. The wireless section checks access points online, that a test device joins each network, and that any guest network is kept apart from the staff network. Each section ends with a pass, fail or not tested result.
Where do the pass and fail limits come from?
From the project specification. You enter each limit as written there, such as the allowed level difference between seats or the target signal for an access point, and the form compares your reading with it. If you do not have the specification with you, the form says to record what you find but not to mark a test as passed.
Does this cover commissioning under the Building Regulations?
No. In England, regulation 44 of the Building Regulations 2010 requires, where it applies, a notice to building control confirming that fixed building services have been commissioned under an approved procedure. This form records AV and network tests. It does not give that notice or replace the CIBSE or BSRIA procedures.
How are snags recorded?

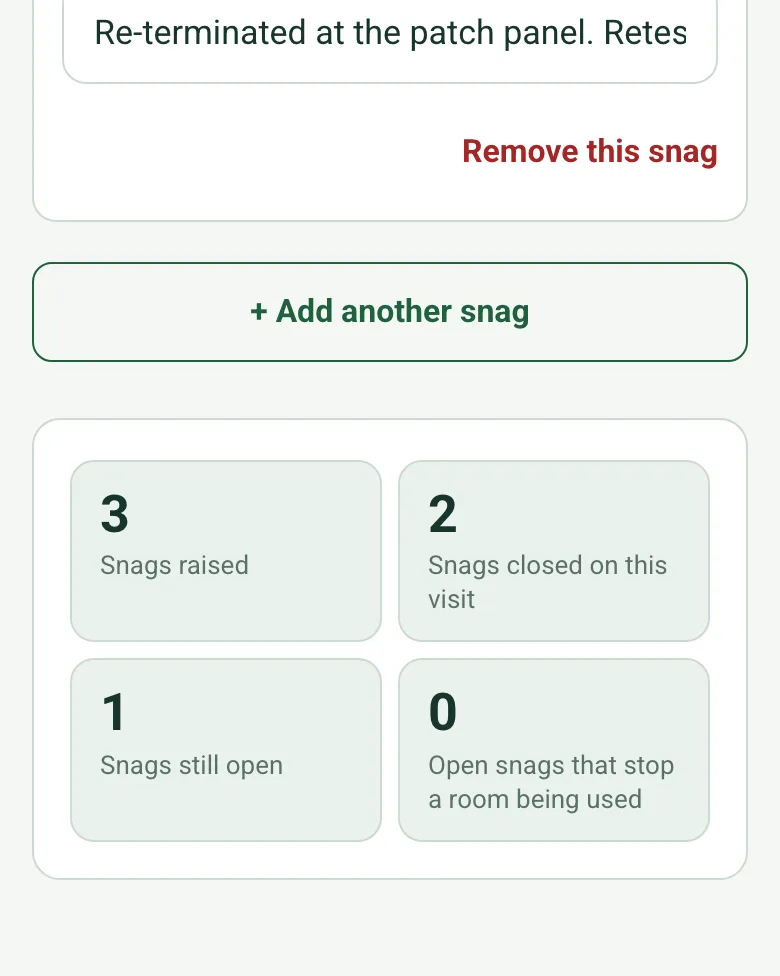

Each snag records what is wrong and where, its effect on handover, photos, and either what was done to fix it on the visit or who will fix it and by when. A snag that stops the room being used should be closed and tested again before the client is asked to sign. The form counts the snags raised, closed and still open.
What does the client's signature confirm?
It records that the client saw the systems working as described on that date. It does not replace the contract or the warranty. If the client is not there to countersign, the form records the date of the client walkthrough instead.
Should passwords go on the commissioning record?
No. The form asks whether passwords or logins were handed over and records only who received them and how. The handover section also lists the documents given to the client and any still to come.
Related
Related templates
Templates that go with the commissioning form
Room survey for AV installs: dimensions, photos, power and data, ceiling and structure, equipment positions, access.
Containment and cable routes, comms room and cabinet, power and cooling, existing and required outlets by area.
Cabinet by cabinet audit: equipment by U position, power, cooling, labelling, cable management.
Per screen: mounting, height, fixings, power and signal, final picture test and photos.
